Chapter 15: Governance Framework

Learning Objectives

After completing this chapter, you will be able to:

  • Establish OCM governance structures and bodies
  • Define roles, responsibilities, and decision rights
  • Create governance processes for OCM activities
  • Integrate OCM governance with project and IT governance
  • Monitor and enforce governance compliance

The Need for OCM Governance

OCM governance provides the structures, processes, and authority necessary to ensure that organizational change management is practiced consistently and effectively across the enterprise. Without governance, OCM quality varies by project and practitioner, best practices are not shared, and organizational learning does not occur.

Governance serves multiple purposes:

Consistency: Ensures OCM is applied using common approaches and standards

Quality: Maintains OCM quality through reviews and oversight

Accountability: Establishes clear ownership for OCM outcomes

Integration: Connects OCM with project, IT, and enterprise governance

Continuous Improvement: Enables learning and practice advancement


Governance Structure

OCM Governance Bodies

Depending on organizational size and OCM maturity, governance may include:

OCM Steering Committee

  • Strategic direction for OCM practice
  • Resource allocation decisions
  • Policy approval
  • Cross-initiative prioritization

OCM Center of Excellence (CoE)

  • Methodology ownership and development
  • Practitioner support and consultation
  • Training and capability building
  • Best practice identification and sharing

OCM Community of Practice (CoP)

  • Peer learning and knowledge sharing
  • Tool and template development
  • Problem-solving collaboration
  • Practice improvement suggestions

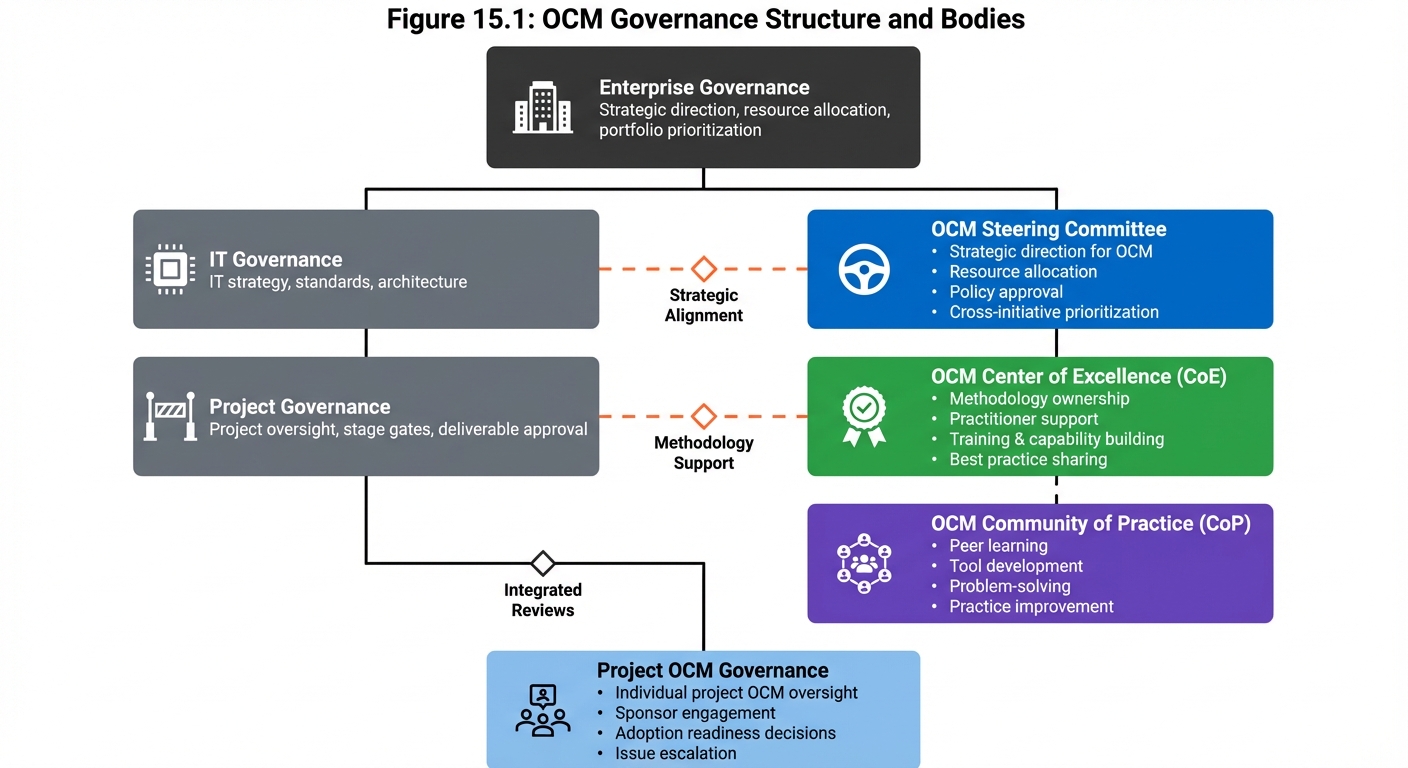

Figure 15.1: OCM Governance Structure

Figure 15.1 - OCM Governance Structure: Effective OCM governance integrates with enterprise and IT governance while providing specialized oversight through dedicated bodies. Clear reporting and coordination relationships ensure alignment.

Project-Level OCM Governance

  • Individual project OCM oversight
  • Sponsor engagement management
  • Adoption readiness decisions
  • Issue escalation and resolution

Governance Integration

OCM governance should integrate with existing governance structures:

Enterprise Governance
        │
        ├── IT Governance
        │       │
        │       └── Project Governance
        │               │
        │               └── OCM Governance (Project Level)
        │
        └── OCM Governance (Enterprise Level)
                │
                ├── OCM Steering Committee
                │
                ├── OCM Center of Excellence
                │
                └── OCM Community of Practice

Roles and Responsibilities

Executive Sponsor

Responsibilities:

  • Champion OCM at executive level
  • Ensure OCM is resourced appropriately
  • Hold leaders accountable for OCM outcomes
  • Remove barriers to OCM effectiveness
  • Model commitment to OCM practices

OCM Practice Lead / Director

Responsibilities:

  • Own OCM methodology and standards
  • Lead OCM Center of Excellence
  • Develop OCM capability across organization
  • Report on OCM effectiveness
  • Drive continuous improvement

Project OCM Lead

Responsibilities:

  • Develop and execute OCM plans for assigned projects
  • Apply OCM methodology and standards
  • Report on OCM progress and issues
  • Escalate risks and barriers
  • Contribute to practice improvement

Project Manager

Responsibilities:

  • Integrate OCM into project planning and execution
  • Allocate resources for OCM activities
  • Support OCM Lead in stakeholder engagement
  • Ensure OCM activities are included in project schedule
  • Account for OCM in project risk management

Business Sponsor

Responsibilities:

  • Own change outcomes and benefits realization
  • Provide visible leadership support
  • Make timely decisions
  • Remove business barriers
  • Hold business stakeholders accountable

Line Managers

Responsibilities:

  • Support OCM activities for their teams
  • Communicate change messages
  • Enable training participation
  • Coach and support individuals
  • Provide feedback on adoption progress

RACI Matrix

ActivityOCM Practice LeadProject OCM LeadProject ManagerBusiness Sponsor
OCM MethodologyA/RCII
OCM Plan DevelopmentCA/RCA
Stakeholder AssessmentCA/RIC
Communication ExecutionIA/RCC
Training DeliveryCA/RCI
Adoption MeasurementCA/RIA
Readiness DecisionCRRA

R = Responsible, A = Accountable, C = Consulted, I = Informed

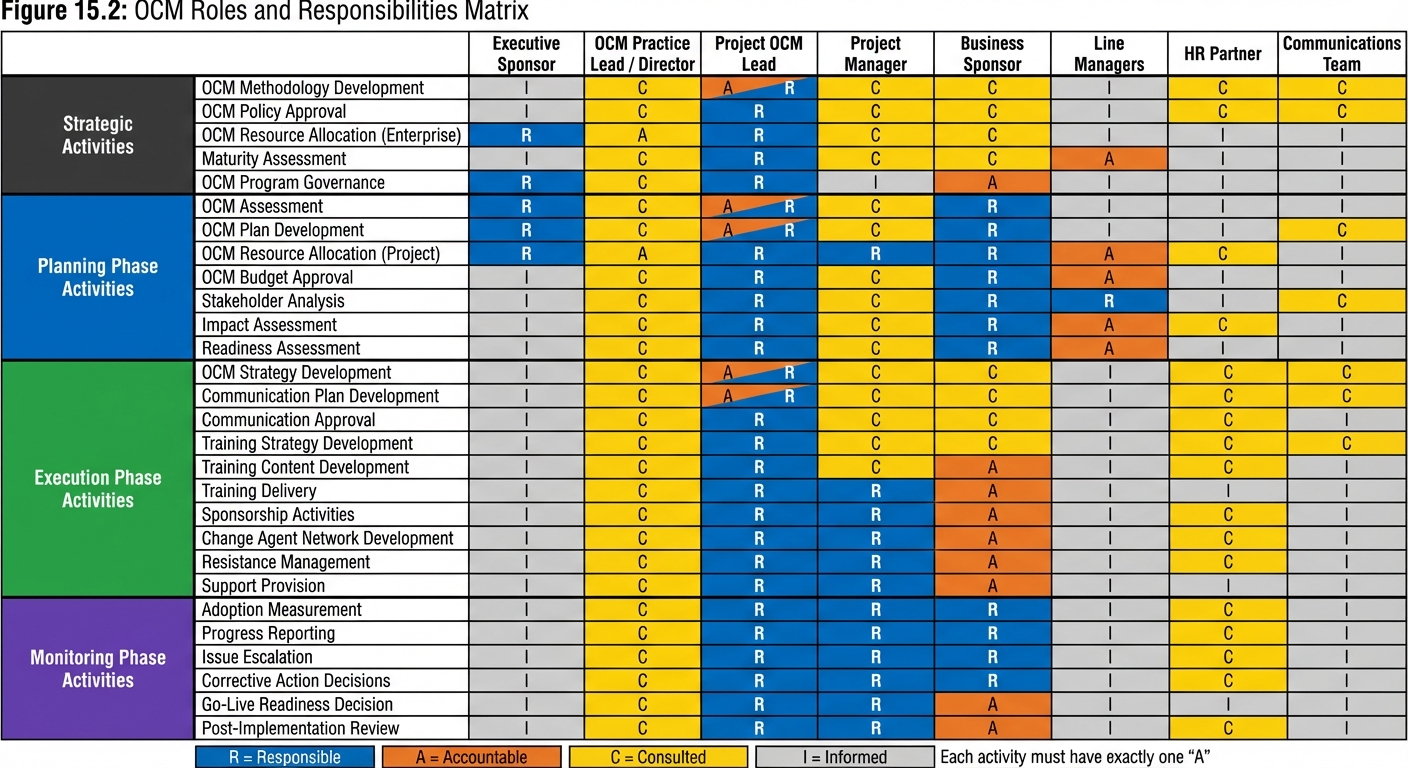

Figure 15.2: OCM RACI Matrix

Figure 15.2 - OCM RACI Matrix: Clear assignment of Responsible, Accountable, Consulted, and Informed roles for all major OCM activities ensures accountability and prevents gaps or overlaps in ownership.


Decision Rights

OCM Decision Framework

Clarify who has authority to make different types of decisions:

Decision TypeDecision MakerInput Required
OCM methodology standardsOCM Practice LeadCoE, CoP
Project OCM approachProject OCM LeadBusiness Sponsor, PM
OCM resource allocationProject Manager/SponsorOCM Lead
Communication contentProject OCM LeadBusiness Sponsor, Legal
Training approachProject OCM LeadTraining, SMEs
Go-live readinessBusiness SponsorOCM Lead, PM
Resistance escalationSponsorOCM Lead, HR
OCM policy exceptionsOCM Practice LeadSteering Committee

Escalation Paths

Define clear escalation paths for OCM issues:

Level 1: Project OCM Lead resolves within project team

Level 2: Project Manager and Business Sponsor involvement

Level 3: OCM Practice Lead and functional leadership

Level 4: OCM Steering Committee for cross-functional issues

Level 5: Executive leadership for strategic decisions

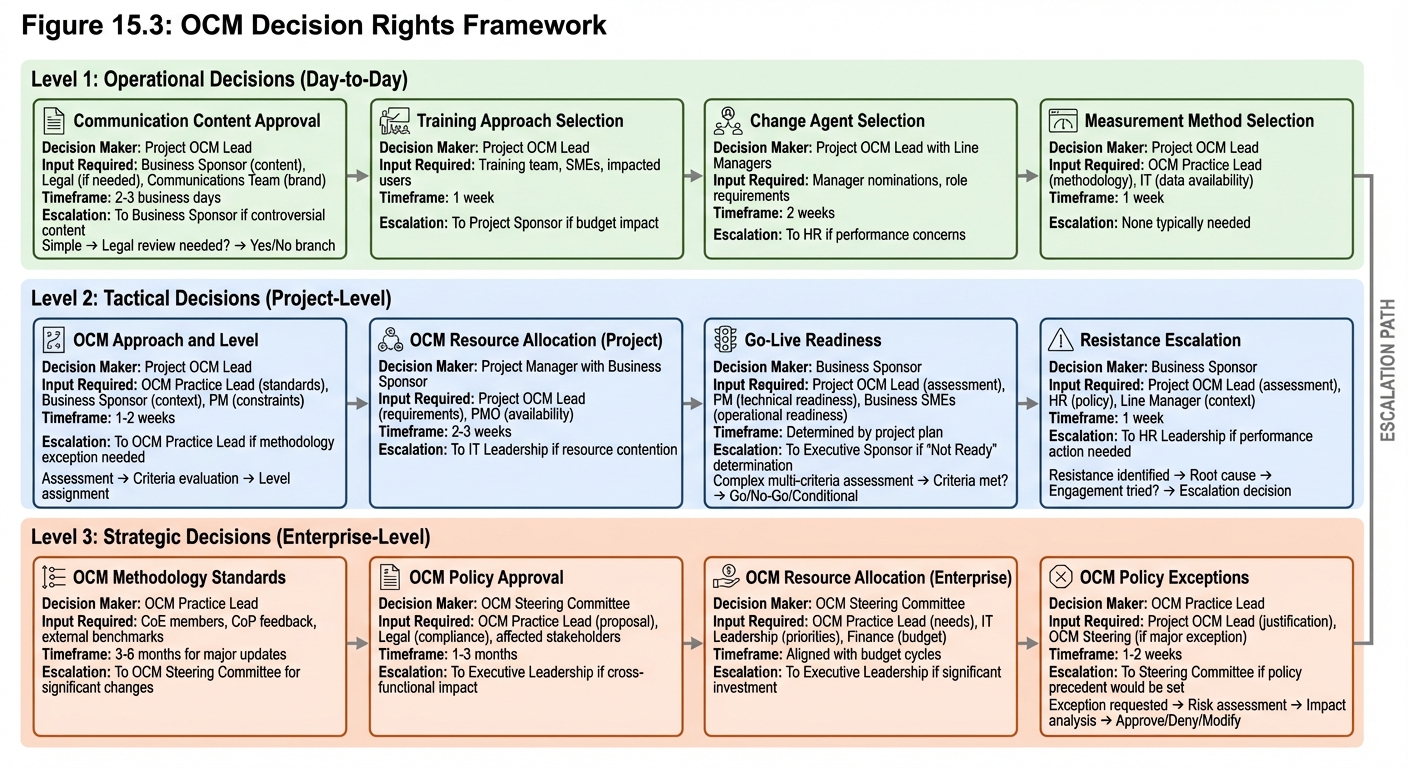

Figure 15.3: OCM Decision Rights Framework

Figure 15.3 - OCM Decision Rights Framework: Clear decision authority eliminates bottlenecks and ambiguity. Operational decisions are made quickly by project teams; tactical decisions involve project sponsors; strategic decisions engage governance bodies.


Governance Processes

OCM Requirements Determination

Process for determining OCM requirements for initiatives:

  1. Initiative Assessment: Evaluate change characteristics
  2. OCM Level Determination: Apply criteria to determine required OCM level
  3. Resource Planning: Identify OCM resource requirements
  4. Plan Review: Review and approve OCM approach
  5. Ongoing Oversight: Monitor OCM execution

OCM Level Criteria:

FactorLevel 1 (Light)Level 2 (Standard)Level 3 (Intensive)
Impacted users<100100-1000>1000
Impact severityLowMediumHigh
Stakeholder complexitySimpleModerateComplex
Change historyPositiveMixedNegative
Strategic importanceLowMediumHigh

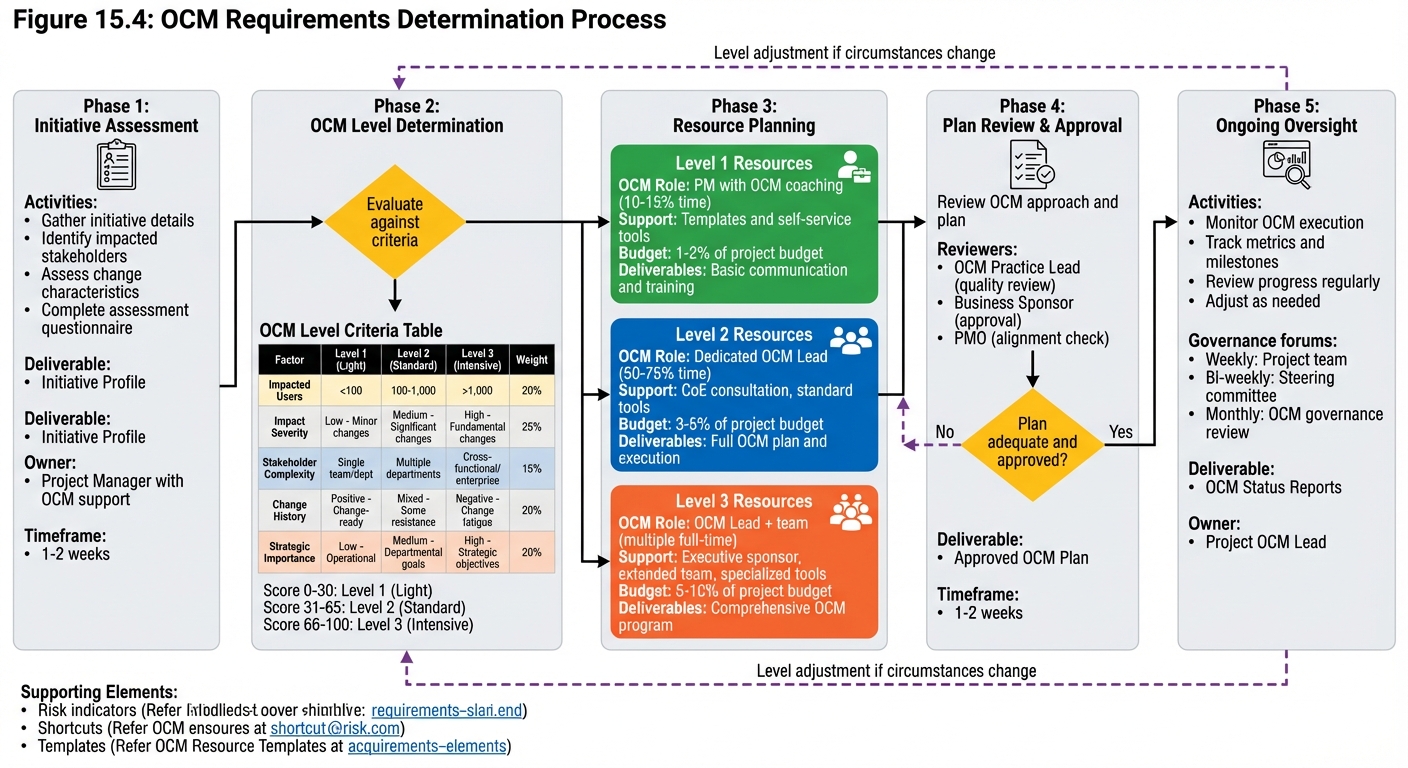

Figure 15.4: OCM Requirements Determination Process

Figure 15.4 - OCM Requirements Determination Process: Systematic assessment determines appropriate OCM level and resources for each initiative. Clear criteria ensure consistent, objective decisions about OCM investment.

OCM Plan Review

Process for reviewing and approving OCM plans:

  1. Plan Submission: OCM Lead submits plan using standard template
  2. Quality Review: CoE reviews for completeness and quality
  3. Sponsor Review: Business Sponsor reviews and approves
  4. Updates: Plan updated based on feedback
  5. Approval: Final approval from appropriate authority
  6. Baseline: Approved plan baselined for tracking

Readiness Assessment

Process for assessing go-live readiness:

  1. Criteria Definition: Define readiness criteria early in project
  2. Assessment Execution: Execute readiness assessment activities
  3. Results Compilation: Compile assessment results
  4. Gap Analysis: Identify gaps against criteria
  5. Recommendation: OCM Lead recommendation on readiness
  6. Decision: Sponsor decision on go-live with OCM input

Sample Readiness Criteria:

  • Awareness: >95% of impacted stakeholders aware
  • Training: >95% of required training completed
  • Proficiency: >80% meeting proficiency standards
  • Sponsorship: All required sponsor activities completed
  • Support: Support structure in place and tested
  • Resistance: Active resistance <15%

Governance Reporting

Standard Reports

Project-Level OCM Status

  • Key metrics against targets
  • Activities completed/planned
  • Issues and risks
  • Support needed

Portfolio-Level OCM Dashboard

  • OCM status across all initiatives
  • Change saturation analysis
  • Resource utilization
  • Trend analysis

Executive OCM Summary

  • High-level adoption status
  • Major issues requiring attention
  • Strategic decisions needed
  • Benefits realization progress

Reporting Cadence

ReportAudienceFrequency
Project OCM StatusProject Team, SponsorWeekly
Portfolio DashboardOCM Steering, IT LeadershipBi-weekly
Executive SummaryExecutive TeamMonthly
Maturity AssessmentOCM SteeringAnnually

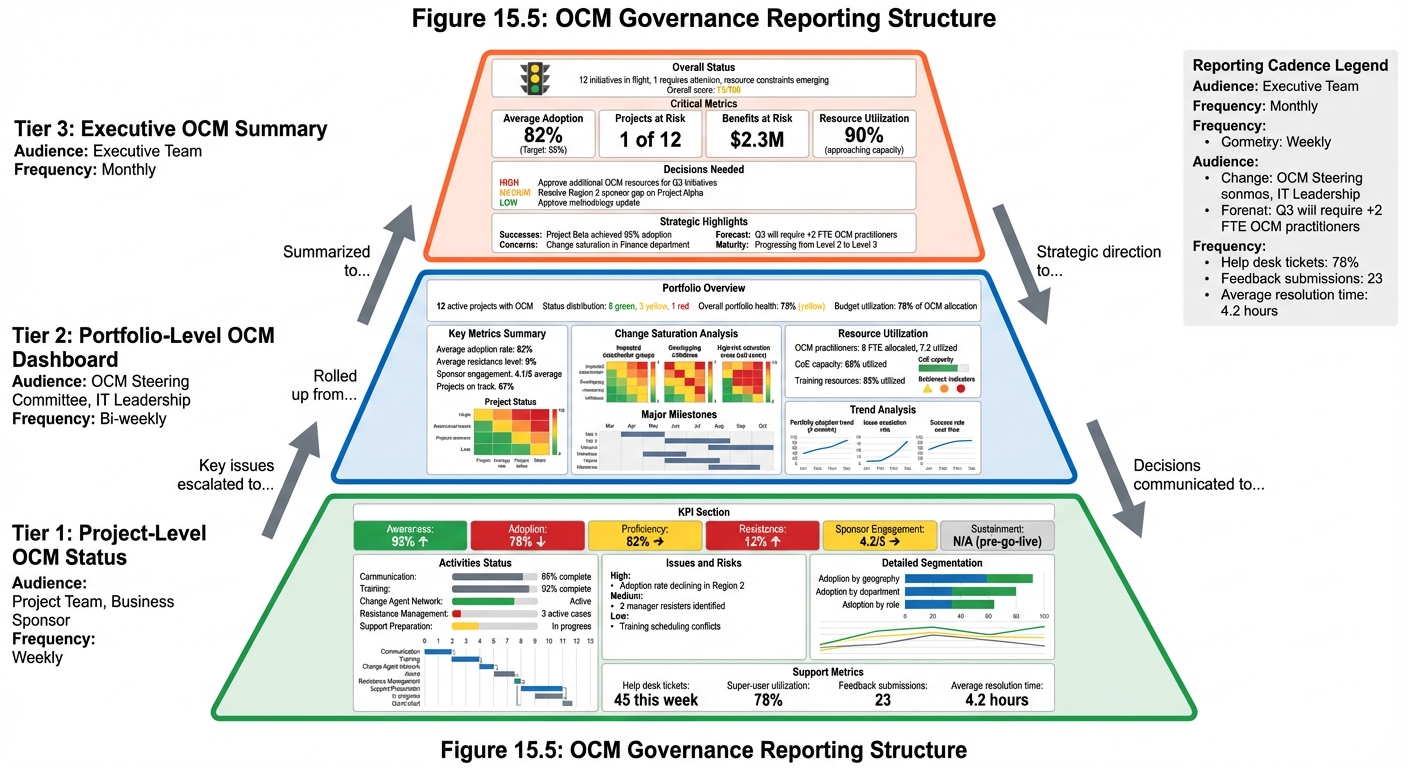

Figure 15.5: OCM Governance Reporting Structure

Figure 15.5 - OCM Governance Reporting Structure: Information flows from detailed project reports to portfolio dashboards to executive summaries. Each level provides appropriate detail for its audience while maintaining end-to-end visibility.


Key Takeaways

  • Governance structures (steering committees, CoE, CoP) provide oversight and support
  • Clear roles and responsibilities ensure accountability for OCM outcomes
  • Decision rights clarify who has authority for different decisions
  • Governance processes ensure consistent application of OCM practices
  • Reporting keeps stakeholders informed and enables oversight
  • Balance rigor with enablement—governance should help, not hinder

Summary

OCM governance provides the structures, processes, and authority necessary for consistent, effective organizational change management. Governance bodies at enterprise and project levels provide oversight and support. Clear roles, responsibilities, and decision rights establish accountability. Governance processes ensure OCM is applied consistently across initiatives.

Effective governance balances oversight with enablement—providing enough structure to ensure quality and consistency while not creating bureaucracy that impedes agility. The goal is to help OCM practitioners succeed, not to create administrative burden.
